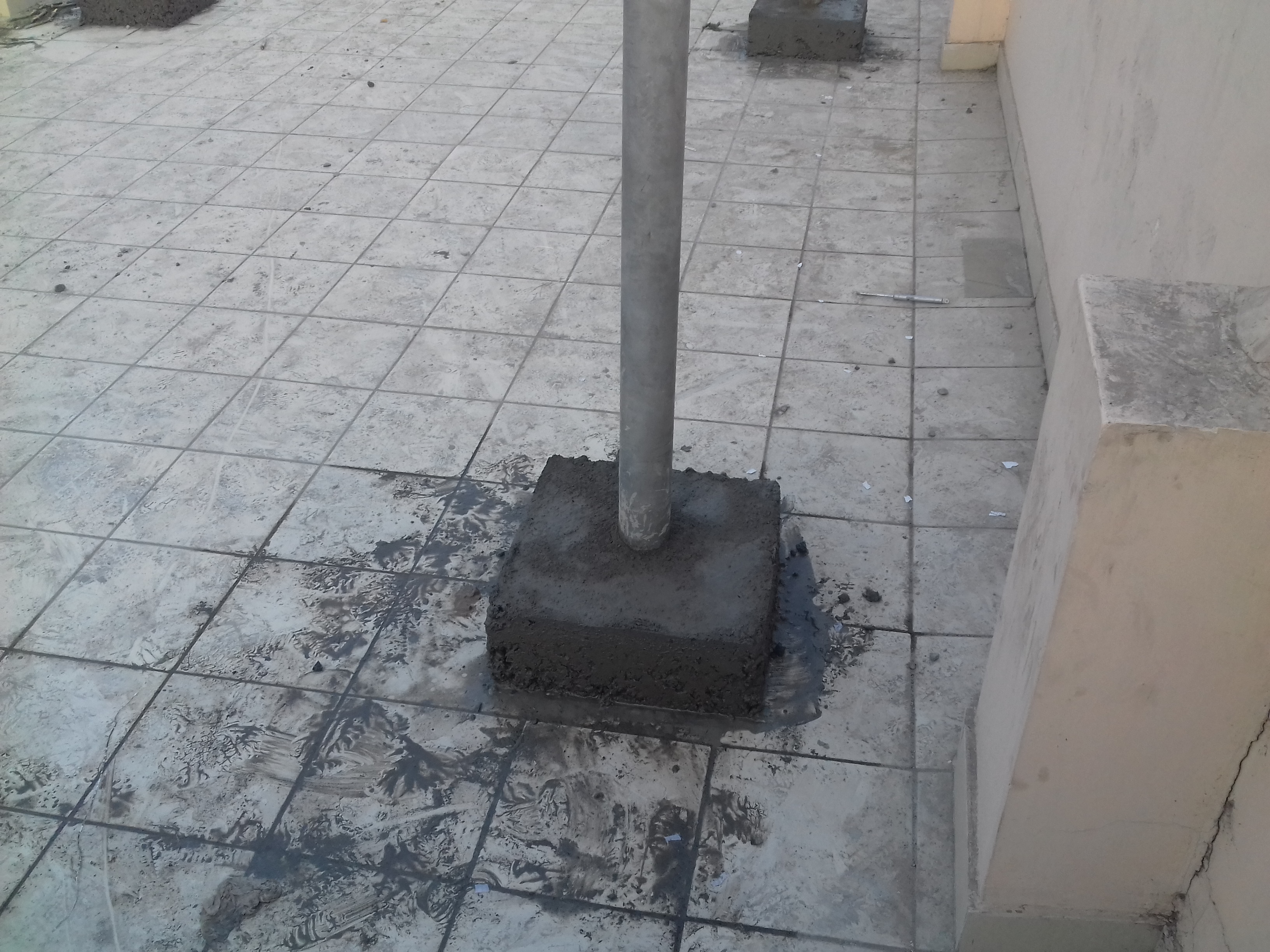

Team Loyal started the installation of a 10KW Grid Tied Solar power plant at Sector-15, Sonipat in the first week of January, 2018. We hired the services of our first training batch under their company name Green Times Technologies, Faridabad. The mounting structure used here is a raised structure with minimum height at 8 feet and maximum height at 15.5 feet. We used the earlier followed method of creating concrete pillar upto the existing concrete rooftop and then using 6″ high tensile fasteners for bolting the pillar bases. The pillar bases were then grouted with 1:2:2 concrete boxes of size 1.5×1 sq. ft. The connected load at the site is 15KW and the 10KW plant will help our customer neutralize his Electricity bill.
